Decommissioning and land remediation

Urenco Nuclear Stewardship provides waste-led decommissioning to the civil nuclear industry through experienced project management practices and waste-informed strategies. The decommissioning activities are integral to the UKs mission to safely and compliantly manage nuclear legacies. Our capabilities include:

  • Transitioning towards decommissioning: moving from nuclear operations to decommissioning.

  • Decommissioning planning: identifying waste-led decommissioning strategies.

  • Proven project management practices: carrying out large-scale projects for the industry.

UUK cylinders

CASE STUDY

Phased demolition of a former gaseous diffusion plant

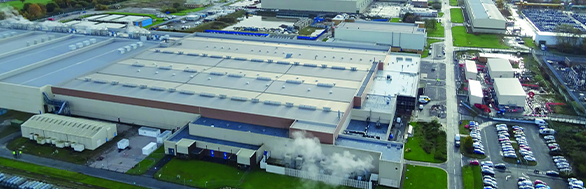

aerial shot of urenco site

Key Facts

Area of demolition

29,000m2

Duration

2010-Present

Decommissioning result

Future re-use

Tonnes of radioactive material disposed

22,000

Number of centrifuges

6 bays

The former Gaseous Diffusion Plant is part of a series of integrated facilities designed and constructed in the early 1950s at Urenco’s Capenhurst site in the UK. Production ceased in the early 1980s, and the site has since undergone a phased programme of refurbishment, decommissioning and demolition.

Through a series of dedicated campaigns, extensive radiological surveys and characterisation activities have been completed. These provide comprehensive data to inform planning and decision-making, enabling a safe, proportionate and risk-based approach to decommissioning.

Our work includes post operational clean out (POCO) activities, such as:

  • Isolation and removal of redundant plant and equipment

  • Re-routing and decommissioning of building services

  • Management of site communications systems and associated infrastructure

Our project teams bring over 30 years of experience in delivering POCO across progressively decommissioned facilities. All works are undertaken in line with current UK legislation and regulatory standards, ensuring safety, compliance and environmental responsibility.

Challenges and Solutions in Project Delivery
Delivering decommissioning at a legacy nuclear facility presents a number of technical and operational challenges. Key activities include:

  • Safety case development and transition
    Updating and modifying the safety case to safely manage the transition from operations to decommissioning.

  • Waste management and environmental protection
    Identifying and implementing bulk disposal opportunities, including collaboration with the Low-Level Waste Repository (LLWR).

  • Security and design optimisation
    Maintaining a proportionate security strategy alongside practical and efficient design solutions.

  • Health, safety and environmental management
    Applying robust controls aligned with CDM 2015 Regulations, ensuring clear duty holder responsibilities and safe delivery.

  • Ageing infrastructure management
    Managing complex and poorly documented assets, including challenging service diversions.

  • Hazard identification and mitigation
    Safely managing a range of hazards, including:
    - Radiological and criticality risks
    - Biological hazards
    - Working at height
    - Asbestos-containing materials
